Old CIDCO building next to a new high-rise under construction in Navi Mumbai redevelopment

Society Redevelopment in Navi Mumbai 2026: Rules, Process, Builder Selection, and Flat Owner Rights

Real Estate Investment

Society redevelopment in Navi Mumbai is no longer a someday conversation. It is happening now. Over 3,000 CIDCO-era buildings across the city are classified as structurally compromised, affecting more than 4 lakh residents. CIDCO’s decision to reduce the consent requirement from 100% to 51% has removed the single biggest roadblock that kept hundreds of societies stuck for years. Combined with revised FSI norms that allow up to 2.5 for residential redevelopment and the handover of building approval authority to NMMC and Panvel Municipal Corporation, the regulatory landscape has finally caught up with the demand.

But here is what most residents do not understand: the process is loaded with financial, legal, and emotional complexity. Picking the wrong builder, signing a weak development agreement, or misunderstanding your rights as a flat owner can cost your family its home for years. This guide walks through the entire redevelopment process in Navi Mumbai with the specificity that matters — CIDCO lease implications, real compensation numbers, builder red flags, RERA protections, and the step-by-step sequence from structural audit to handing over your new flat keys.

Whether you are a flat owner in a 30-year-old CIDCO building weighing your options, an investor evaluating redevelopment upside, or a buyer considering a pre-redevelopment flat for its value gap, this guide is built to answer every question you are likely to have in 2026.

Society redevelopment in Navi Mumbai: the 50-word answer

Society redevelopment in Navi Mumbai replaces aging CIDCO-era buildings with new construction under revised FSI norms. CIDCO now requires only 51% member consent for dilapidated buildings. Flat owners receive a larger replacement flat, monthly rent compensation during construction, a corpus fund, and RERA-backed project monitoring. The process takes 4 to 7 years from audit to possession.

Key takeaways

CIDCO has reduced the consent threshold from 100% to 51% for buildings graded C1 or worse. Revised FSI of 2.5 for qualifying residential buildings means developers can build significantly more on the same plot, funding the entire deal. Over 3,000 buildings across Navi Mumbai are eligible, housing more than 4 lakh residents. NMMC and Panvel Municipal Corporation now handle building plan approvals, not CIDCO. Every redevelopment project must be RERA-registered. Flat owners are entitled to replacement flats with carpet area equal to or greater than their existing unit. Monthly rent compensation, corpus fund, and bank guarantee are standard terms in any credible development agreement.

Quick answers for flat owners considering redevelopment

How much consent is needed? 51% of society members must sign an irreversible consent letter for buildings classified as dilapidated.

How long does it take? 4 to 7 years from structural audit to possession of your new flat. Approval phase: 6 to 12 months. Construction: 3 to 5 years.

What do I get? A new flat with carpet area equal to or greater than your current flat (most developers offer 20 to 40% additional area), monthly rent compensation, a one-time corpus fund, and a bank guarantee protecting your investment.

Do I need to pay anything? No. The developer bears all construction costs. Your existing flat is your equity in the deal.

Is it safe? If the project is RERA-registered, the development agreement is legally reviewed, and the builder provides a bank guarantee, the risk is manageable. Without these safeguards, it is not.

Investment snapshot: redevelopment economics in Navi Mumbai 2026

Current FSI for redevelopment: Up to 2.5 for C1 category residential buildings over 30 years old. Original CIDCO-era buildings were built at FSI 1.0 to 1.5, meaning the buildable area roughly doubles.

Property value uplift: A 500 sq ft flat in a 35-year-old CIDCO building in Vashi valued at ₹60 to ₹70 lakh today could become a 650 to 700 sq ft flat in a new building valued at ₹1.2 to ₹1.5 crore post-redevelopment. The value gap is the core investment thesis.

Rental yield during construction: Monthly rent compensation of ₹12,000 to ₹25,000 depending on area and flat size, paid by the developer for 3 to 5 years.

Corpus fund: One-time payment of ₹2 to ₹5 lakh per member deposited into the society’s account.

Risk factor: Builder abandonment, approval delays, and cost overruns. Mitigated by RERA registration and bank guarantee clauses.

Why society redevelopment in Navi Mumbai is accelerating in 2026

Three structural changes have shifted the math. First, CIDCO reduced the consent requirement from 100% to 51% for buildings classified as dilapidated. That single policy change unlocked hundreds of buildings that were stuck for years because one or two members refused to participate. Under the old rule, a single holdout could block an entire society of 150 families from pursuing redevelopment. That leverage is gone.

Second, property values in Navi Mumbai have risen sharply. Areas like Vashi, Nerul, and Kopar Khairane have seen values climb 35 to 50% over the last three years. Higher end-sale prices make the redevelopment economics work for builders. They can offer larger replacement flats, bigger corpus funds, and still make their margins on the surplus saleable area.

Third, the revised FSI norms allow significantly more construction on the same plot. Most CIDCO-era buildings were built at FSI 1.0 to 1.5. Current norms allow FSI up to 2.5 for qualifying residential redevelopment, effectively doubling the buildable area. That surplus is what funds the entire deal. The developer sells the extra flats at market rate and uses those proceeds to finance the replacement flats, rent compensation, and corpus fund for existing members.

CIDCO has also handed over building approval authority to NMMC and Panvel Municipal Corporation, streamlining the approval process. Earlier, societies had to navigate both CIDCO and municipal approvals sequentially. Now the municipal corporation is the primary authority, with CIDCO’s role limited to lease compliance verification.

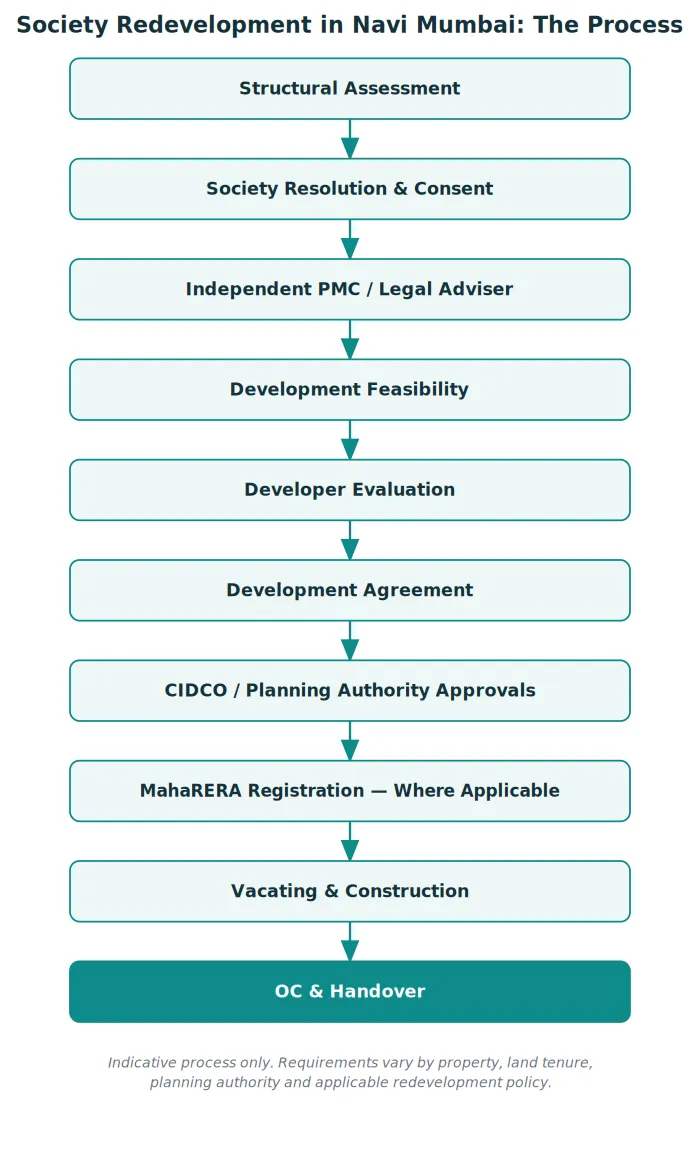

The redevelopment process: step by step

Step 1: Structural audit

The society commissions a structural audit from a government-approved structural engineer registered with the Indian Institution of Structural Engineers or an equivalent body. The audit grades the building on a scale: C1 (repairable with major work), C2 (structurally unsound, beyond economical repair), or D (dangerous, must be vacated immediately). Only C1, C2, and D grade buildings qualify for redevelopment under current CIDCO and NMMC norms. The audit report is the foundational document that triggers the entire process.

Cost of a structural audit in Navi Mumbai runs ₹50,000 to ₹1,50,000 depending on the building size. The society bears this cost. Avoid using engineers recommended by developers, as there is a conflict of interest. Hire independently.

Step 2: General body resolution and consent collection

The society calls a special general body meeting to pass a resolution for redevelopment. Under CIDCO’s revised rules, 51% of members must sign an irreversible consent letter agreeing to demolition and reconstruction. The consent is individual and must be notarised. Once signed, a member cannot withdraw consent unless the development agreement is materially breached by the developer.

This stage is where most societies face internal conflict. Members who have already moved out and rent their flat may have different priorities than those living in the building. Elderly residents may resist the disruption. Families with school-going children worry about relocation timing. The managing committee needs to address each constituency’s concerns transparently before pushing for consent. Rushed consent drives lead to legal challenges later.

Step 3: Appoint a project management consultant

Before selecting a builder, smart societies hire an independent project management consultant or a specialised redevelopment lawyer. The PMC drafts the tender document, sets minimum eligibility criteria for developers, evaluates bids objectively, and negotiates the development agreement on behalf of the society. Cost: ₹5 to ₹15 lakh for the full engagement, shared across all members. This is the most important ₹3,000 to ₹10,000 per flat you will ever spend. Societies that skip this step and negotiate directly with builders almost always end up with weaker terms.

Step 4: Builder selection through competitive tender

The society floats a tender inviting developers to submit proposals. The tender should specify minimum criteria: RERA registration of at least 3 previous projects, minimum net worth, no pending RERA complaints, and demonstrated experience with CIDCO redevelopment. Each proposal must detail the replacement flat carpet area, corpus fund per member, monthly rent compensation, construction timeline, bank guarantee amount, construction quality specifications (including brand specifications for fittings, flooring, and electrical), penalty clauses for delays, and the number of saleable flats the developer plans to build.

Evaluate at least 3 to 5 proposals. Visit the developer’s completed projects. Talk to residents of their previous redevelopment projects. Check MahaRERA for complaints or project delays. The lowest corpus fund offer is almost never the best deal. Look at the complete package: flat size, construction quality, timeline credibility, and financial backing.

Step 5: Development agreement

Once a builder is selected by majority vote, the society signs a development agreement. This is the single most important document in the entire redevelopment process. Every term must be in writing. Verbal promises have zero legal standing.

The agreement must specify: exact replacement flat carpet area (measured per RERA definition, not super built-up), floor and wing allocation mechanism, corpus fund amount and payment timeline, monthly rent compensation with annual escalation clause (typically 5 to 10% per year), construction completion deadline with liquidated damages for delay (typically ₹50 to ₹100 per sq ft per month of delay), bank guarantee amount and issuing bank, construction quality specifications down to brand names for tiles, sanitary ware, electrical switches, and lifts, RERA registration commitment with project number, dispute resolution mechanism (arbitration is standard), and termination conditions if the developer defaults.

Get the agreement reviewed by an independent property lawyer. Not the society’s regular lawyer. Not the developer’s lawyer. An independent specialist in redevelopment law. Budget ₹50,000 to ₹1,00,000 for this review. It will save you from clauses that look harmless but strip your rights.

Step 6: CIDCO NOC and municipal approvals

Since the plot is on CIDCO leasehold land, the society must obtain CIDCO’s prior written permission for demolition. Apply at CIDCO Bhavan, CBD Belapur. CIDCO verifies that the lease is current, no dues are pending, and the redevelopment complies with lease conditions. Processing time: 15 to 30 days.

Separately, the developer applies for building plan approval from NMMC or Panvel Municipal Corporation. This involves submitting architectural drawings, structural calculations, fire safety compliance, and environmental clearance. Processing time: 3 to 9 months depending on complexity and approvals backlog. Both approvals must be in place before demolition can begin.

Step 7: Vacate, demolish, and build

Once approvals are in hand, the developer issues a vacation notice. Members vacate the building, demolition begins, and construction starts. Members receive their first rent compensation payment before or at the time of vacating. Construction timelines in Navi Mumbai typically run 3 to 5 years depending on project size, approval pace, and monsoon interruptions. The developer must provide quarterly progress reports to the society and to MahaRERA.

Flat owner rights during society redevelopment

Your rights are defined by three layers of law: the development agreement, the Maharashtra Ownership Flats Act (MOFA), and RERA. Here is what you are entitled to and what you should never compromise on.

Replacement flat with equal or greater carpet area. The developer must provide a new flat with carpet area (measured per RERA definition) at least equal to your existing flat. Most developers in Navi Mumbai currently offer 20 to 40% additional area as an incentive. Get the exact measurement in the development agreement, not a vague percentage promise.

Monthly rent compensation. The developer pays monthly rent to each displaced member for the entire construction period. Current market rates in Navi Mumbai range from ₹12,000 to ₹25,000 per month depending on flat size and area. The agreement must include an annual escalation clause of 5 to 10%. If construction takes longer than the agreed timeline, rent payments must continue at the escalated rate.

Corpus fund. A one-time payment deposited into the society’s account to cover future maintenance of the new building. In Navi Mumbai, corpus amounts currently range from ₹2 to ₹5 lakh per member. This is in addition to rent compensation, not a substitute for it.

Bank guarantee. The developer must provide an irrevocable bank guarantee from a nationalised bank, equivalent to the estimated construction cost of all replacement flats. This protects members if the developer abandons the project midway. No bank guarantee means no deal. This is non-negotiable.

RERA registration. Every redevelopment project must be registered under MahaRERA. This gives flat owners access to the RERA complaint mechanism, ensures quarterly progress reporting, and provides a legal framework for compensation if the developer defaults on timelines.

Right to information. Under MOFA and RERA, society members have the right to inspect all project-related documents including building plans, IOD, CC, OC application status, and financial accounts of the project. Any developer who denies access to these documents is violating the law.

CIDCO lease complications: what Navi Mumbai flat owners must know

This is the section that trips up most societies and most real estate articles ignore entirely.

The plot under your CIDCO building is not owned by your society. It is leased from CIDCO for 60 or 99 years depending on when the allotment was made. CIDCO retains ownership rights over the plot. The society holds a leasehold interest, not freehold ownership. This distinction matters at every stage of redevelopment.

Before demolition, the society must obtain a No Objection Certificate from CIDCO confirming that the lease is current, no dues are pending, and the redevelopment does not violate lease terms. Without this NOC, neither NMMC nor Panvel Municipal Corporation will approve building plans.

If your society’s lease is nearing expiry, get it renewed before initiating redevelopment. An expired or expiring lease makes it impossible for the developer to obtain building plan approval. Lease renewal involves a premium payment to CIDCO, typically calculated on the current ready reckoner rate. Factor this cost into the redevelopment equation early.

Transfer premium is another CIDCO-specific cost. If the original allotment had a restriction on resale within a specific period, CIDCO charges a transfer premium when the property changes hands. Check with the CIDCO Bhavan, CBD Belapur, for the applicable premium before signing any development agreement.

Flat owner checklist before signing any development agreement

Print this list and check every item before you put your signature on anything.

Structural audit completed by an independent engineer (not recommended by the developer). 51% consent collected with notarised irreversible consent letters. Independent PMC or redevelopment lawyer appointed by the society. Minimum 3 developer proposals evaluated through competitive tender. Developer’s MahaRERA track record checked for complaints and delays. Previous redevelopment projects visited and residents interviewed. Development agreement reviewed by an independent property lawyer. Replacement flat carpet area specified in exact square feet per RERA definition. Monthly rent compensation amount, escalation clause, and start date specified. Corpus fund amount and payment timeline specified. Bank guarantee from a nationalised bank, amount equivalent to construction cost. Construction timeline with penalty clause for delay specified. Construction quality specifications with brand names for all fittings. RERA registration number included in the agreement. Dispute resolution mechanism specified (arbitration is standard). Termination and exit clauses reviewed.

Expert insights: red flags when selecting a builder

Developers who refuse to provide a bank guarantee are not worth your time. If a builder says the bank guarantee will come later or offers a personal guarantee instead, walk away. A personal guarantee from a developer has zero enforcement value if the company goes bankrupt.

Be cautious of developers offering significantly more than the market rate. If every other developer is offering 25% extra area and one is promising 60%, the numbers almost certainly do not work. That developer is either planning to cut construction quality, inflate the project cost later, or abandon the project once approvals get complicated.

Check the developer’s financial health, not just their portfolio of completed projects. A developer who has completed 10 projects but is currently over-leveraged with 15 active projects may not have the financial capacity to add yours. Ask for audited financial statements or at least a CA-certified net worth certificate.

Never sign a development agreement without independent legal review. The ₹50,000 to ₹1,00,000 you spend on a specialist redevelopment lawyer will protect you from clauses that look harmless but give the developer disproportionate control over timeline extensions, specification downgrades, and cost escalation pass-throughs.

Market outlook: redevelopment trajectory in Navi Mumbai

The redevelopment wave in Navi Mumbai is still in its early stages. Of the 3,000+ eligible buildings, fewer than 200 have completed or are actively under construction as of 2026. The pipeline is enormous. Nodes like Vashi, Nerul, Kopar Khairane, and Sanpada have the highest concentration of eligible buildings and will see the most activity over the next 5 to 10 years.

Property values in pre-redevelopment buildings currently trade at a 30 to 50% discount to new construction in the same micro-market. As redevelopment projects complete and deliver, that discount gap will narrow. For investors, buying a flat in a pre-redevelopment society at today’s prices and waiting for the new flat delivery represents one of the highest-return real estate plays available in the Mumbai Metropolitan Region.

The risk is timeline uncertainty. A 5-year construction estimate can stretch to 7 or 8 years with approval delays, developer financial stress, or resident disputes. The rent compensation covers your housing costs during this period, but the capital is locked. Factor in the opportunity cost of illiquidity when making your investment decision.

Pros and cons of society redevelopment in Navi Mumbai

Pros: Larger flat in a new building at zero cost to the owner. Significant property value appreciation post-redevelopment. Monthly rent compensation covers interim housing. Corpus fund provides additional financial benefit. Modern building amenities like lifts, fire safety, parking, and earthquake resistance. Stronger title documentation under RERA.

Cons: 4 to 7 year displacement from your home. Emotional stress of relocation, especially for elderly residents and families with children. Risk of builder delays or abandonment if safeguards are weak. CIDCO lease complications can add time and cost. Internal society disputes can stall the process. Capital locked during construction period with no exit liquidity.

Frequently asked questions

What is the consent requirement for society redevelopment in Navi Mumbai?

CIDCO requires 51% member consent for buildings classified as dilapidated (C1 grade or worse). Members sign an irreversible notarised consent letter agreeing to demolition and reconstruction. The earlier requirement was 100%, which has been relaxed to accelerate redevelopment across the city’s 3,000+ eligible buildings.

How long does society redevelopment take in Navi Mumbai?

Expect 4 to 7 years from the structural audit to possession of your new flat. The approval phase takes 6 to 12 months, construction runs 3 to 5 years, and OC and handover add another 3 to 6 months. CIDCO NOC and lease renewal can extend the timeline further.

What rent compensation do flat owners get during redevelopment?

Monthly rent compensation in Navi Mumbai ranges from ₹12,000 to ₹25,000 depending on the flat size and area. The development agreement should include a 5 to 10% annual escalation clause. Payments must continue until you take possession of your new flat, regardless of construction delays.

What is the FSI allowed for redevelopment in Navi Mumbai?

Current norms allow FSI up to 2.5 for C1 category residential buildings over 30 years old. Original CIDCO-era buildings were built at FSI 1.0 to 1.5. The surplus FSI is what funds the economics of the deal, allowing developers to build and sell additional flats at market rate.

Does CIDCO need to approve redevelopment of its buildings?

Yes. Since plots are on CIDCO leasehold land, a CIDCO NOC is required before demolition. Apply at CIDCO Bhavan, CBD Belapur. Building plan approval comes separately from NMMC or Panvel Municipal Corporation. Both approvals are mandatory before construction begins.

What should the development agreement include?

At minimum: replacement flat carpet area per RERA definition, corpus fund amount, monthly rent compensation with escalation, construction timeline with penalty clause, bank guarantee from a nationalised bank, construction quality specifications with brand names, RERA registration number, and dispute resolution mechanism. Get independent legal review before signing.

Can I buy a flat in a pre-redevelopment society as an investment?

Yes, and it can be a high-return play. Pre-redevelopment flats trade at 30 to 50% below new construction prices in the same area. Post-redevelopment, you receive a larger flat in a new building at significantly higher market value. The risk is timeline uncertainty and capital illiquidity during the 4 to 7 year construction period.

What happens if the builder abandons the redevelopment project?

If the development agreement includes a bank guarantee from a nationalised bank, the society can invoke the guarantee and use the funds to appoint a new developer. RERA also provides a complaint mechanism for project delays and defaults. Without a bank guarantee, recovery options are limited to lengthy civil litigation.

Is society redevelopment in Navi Mumbai worth it?

For most flat owners in buildings over 30 years old, yes. The combination of a larger flat, modern amenities, significant value appreciation, and rent compensation during construction makes it financially compelling. The key is ensuring the development agreement has strong safeguards including a bank guarantee, RERA registration, and penalty clauses for delays.

How do I check if my building qualifies for redevelopment?

Commission a structural audit from an independent government-approved structural engineer. Buildings graded C1 (needs major repair), C2 (beyond economical repair), or D (dangerous) qualify. The building must be on CIDCO-allotted land and the CIDCO lease must be current. Contact your society managing committee to initiate the process.
